Solar Interconnection: What Businesses Need to Know Before Going Solar

A solar proposal can look like a good investment before the utility has confirmed how the system can connect to the grid. Estimating the financial impact of solar interconnection early helps a business decide what it can afford to commit before that review is complete.

Take Ridgeline Manufacturing, a hypothetical business considering a 1 MW rooftop system. The proposal estimates a project cost of $1.8 million and annual energy savings of $220,000. Then the utility reviews the proposed connection and finds that the local power line serving the site needs an upgrade for the system to operate as proposed. In this example, the upgrade adds $250,000 to the project and pushes the operating date back six months.

The panels haven’t gotten more expensive. The cost of getting the project connected has changed. When the proposal goes back to management, the team needs to answer a different question: does the investment still make sense at $2.05 million, with savings starting six months later?

What Solar Interconnection Involves

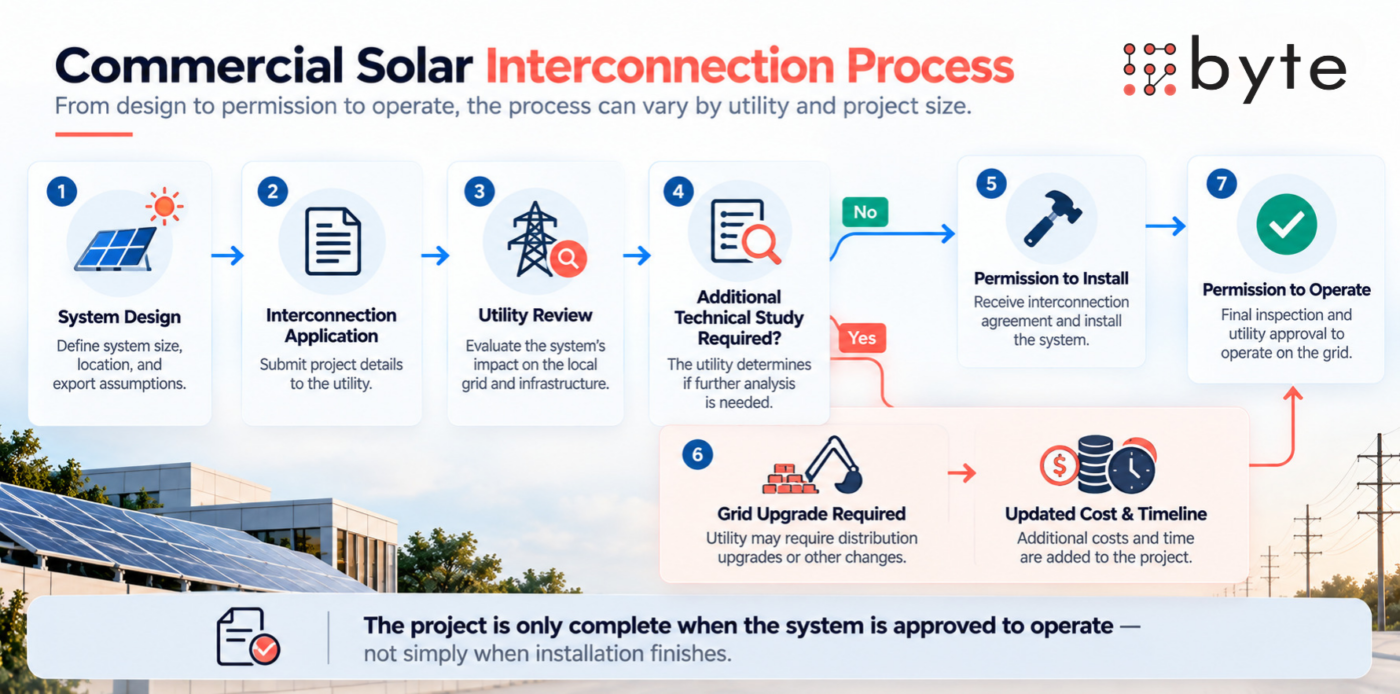

Commercial solar interconnection process: system design, application, utility review, technical study, permission to install and permission to operate

Solar interconnection is the process of getting a proposed solar system approved to connect to the electric grid. The project team typically submits details about the system and how it will operate. The utility reviews the proposal and may ask for more information, require a study, or specify conditions for the connection.

The steps and timelines vary. Ask the utility which steps apply to your site, which costs are still estimates, and what needs to happen before the system can start operating. Building and electrical permits follow separate approval processes. Track the status of those permits and the utility’s permission to operate separately so the project schedule reflects what is actually complete.

What the Utility Needs to Know

For a commercial solar interconnection application, ask your installer or engineer to walk you through four details:

  • System size and connection point: What capacity is being proposed, and where would the system connect to the property’s electrical service?
  • On-site use and exports: How much electricity is the business expected to use on-site, and how much could flow back to the grid?
  • Existing equipment: Which service equipment, transformers, or parts of the local distribution network could affect the connection?
  • Design conditions: Are there potential requirements for controls, protection equipment, operating limits, or upgrades?

An export limit matters to the financial model. If a revised design changes how much solar electricity the business can use or export, revisit the savings estimate along with the installation cost. Ask the project team to model any alternative the utility indicates it can review. At Ridgeline, for example, a design with less export might change the upgrade scope, but management would need a new cost and savings estimate before comparing it with the original proposal.

How the Upgrade Changes the Business Case

Ridgeline’s original simple payback was about 8.2 years: $1.8 million divided by $220,000 in annual savings. The $250,000 upgrade raises that estimate to about 9.3 years if annual savings stay the same. The six-month delay is a separate change: the business starts saving later, and some project payments may still be due before the system operates.

Illustrative scenario Project cost Simple payback, excluding the wait before operation Start of savings
Original proposal $1.80 million 8.2 years As planned
Upgrade only $2.05 million 9.3 years As planned
Delay only $1.80 million 8.2 years Six months later
Upgrade and delay $2.05 million 9.3 years Six months later

All four scenarios assume $220,000 in annual savings once the system is operating. Simple payback divides project cost by annual savings. The six-month wait is shown separately because it delays those savings without changing this calculation. The estimate excludes financing, maintenance, incentives, and the time value of money. Use it to see what the upgrade does to the payback estimate, then use the cash-flow model to decide whether the combined scenario still clears the company’s investment threshold. Our article on how financial models support investment decisions explains how to compare assumptions before committing capital.

Put the Utility Review Into the Cash-Flow Forecast

Model the dates the company expects to pay for design, equipment, installation, and any utility work. Put expected energy savings in the months when the system can operate. If solar interconnection pushes that date back, move the savings and check whether any financing or other carrying costs increase during the wait.

For Ridgeline, the combined case belongs in the approval discussion because both changes came out of the same review. If the utility review also leads to a redesign, rerun the model with the revised output and export assumptions. Keep the original proposal in the comparison so management can see what changed and why. For help laying out payment dates and testing timing changes, see our cash-flow forecasting guide.

What to Ask Before Signing a Solar Proposal

Ask the installer and project lead to walk through these questions with the latest information from the utility:

  • What has the utility reviewed so far? Confirm whether the application has been submitted and which system size and export assumptions it uses.
  • Which costs are firm? Identify any allowances for utility studies, engineering, or upgrades and establish who would pay if those costs rise.
  • Which approvals remain open? Name the party responsible for each one, and check how the remaining steps could affect the expected operating date.
  • What can we commit to now? Review when deposits become due and what the contract says about changes or cancellation if the approved design differs from the proposal.
  • When would we reconsider the investment? Agree on the cost increase, delay, or reduction in savings that would bring the decision back to management.

Those answers give leadership a basis for deciding whether to proceed, redesign, or wait. Put the decision and its assumptions alongside the company’s other planned investments. Our article on how a business plan supports better business decisions explains how to use the plan to make those tradeoffs visible.

Understand the Connection Before You Commit

Before signing, ask your installer to show which solar interconnection costs and dates are confirmed, which are still estimates, and what happens to your deposit if the approved design changes.

If you’re evaluating solar for your business, Byte Advisory can help you model how changes in project cost, timing, and energy savings affect the investment decision.

[email protected]

byteadvisory.com/contact/
